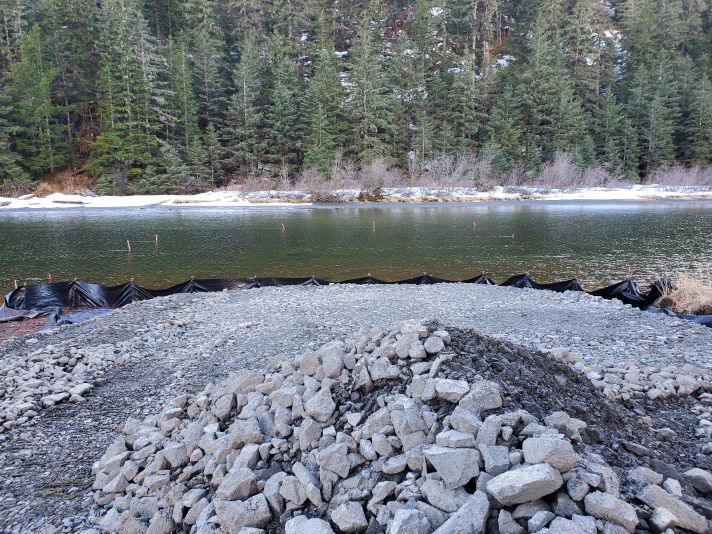

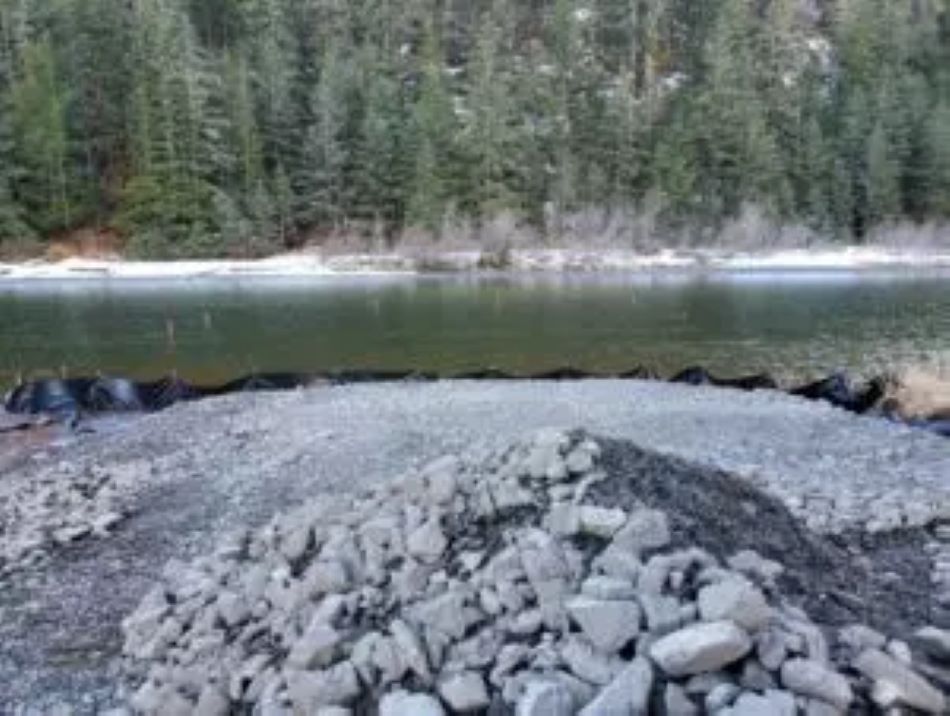

Marked internal work area of where the AquaDam will be placed.
![Eyak River Boat Ramp Installation Cordova, AK 2022](https://www.aquadam.net/content/uploads/2023/12/2Marked-off-Internal-Work-Area-scaled.jpg)
![Eyak River Boat Ramp Installation Cordova, AK 2022](https://www.aquadam.net/content/uploads/2023/12/3Staging-6X-88-Deadman-AquaDam-scaled.jpg)
Staging 6'X88' Deadman AquaDam. The dead-man AquaDam will be used to help the main AquaDam get manipulated into its first turn from upstream to downstream.
![Eyak River Boat Ramp Installation Cordova, AK 2022](https://www.aquadam.net/content/uploads/2023/12/46-X-88-Deadman-getting-deployed-scaled.jpg)
6' X 88' dead-man starting to get deployed. The dead-man is used to break up the flow on the upstream side of where the main AquaDam will be installed.
![Eyak River Boat Ramp Installation Cordova, AK 2022](https://www.aquadam.net/content/uploads/2023/12/5Deadman-elevation-starting-from-Log-scaled.jpg)
Dead-man's starting point was elevated with log so it can fill to its maximum height in the deepest point in the water that it will be placed in.
![Eyak River Boat Ramp Installation Cordova, AK 2022](https://www.aquadam.net/content/uploads/2023/12/6Deadman-filling-up-scaled.jpg)
![Eyak River Boat Ramp Installation Cordova, AK 2022](https://www.aquadam.net/content/uploads/2023/12/76-X-88-Deadman-deployed-scaled.jpg)
Dead-man is filled
![Eyak River Boat Ramp Installation Cordova, AK 2022](https://www.aquadam.net/content/uploads/2023/12/8Side-view-of-deadman-1-scaled.jpg)
![Eyak River Boat Ramp Installation Cordova, AK 2022](https://www.aquadam.net/content/uploads/2023/12/9Fill-tubes-and-hoses-Deadman-scaled.jpg)
Fill Tubes of the dead-man AquaDam. (2) hoses per fill tube. The AquaDam must be filled with pairs of pumps to make sure both sides fill equally.
![Eyak River Boat Ramp Installation Cordova, AK 2022](https://www.aquadam.net/content/uploads/2023/12/10-8-X-357-AquaDam-scaled.jpg)
8' X 357' Main AquaDam on a pallet, ready to be moved to the starting bank. This AquaDam controls a maximum of 74 inches of mud/water depth in ideal condition.
![Eyak River Boat Ramp Installation Cordova, AK 2022](https://www.aquadam.net/content/uploads/2023/12/11Telehandler-Staging-8-X-357-scaled.jpg)
8' X 357' AquaDam being being placed at the staging area which will be the staring point for the AquaDam.
![Eyak River Boat Ramp Installation Cordova, AK 2022](https://www.aquadam.net/content/uploads/2023/12/12Telehandler-Staging-8-X-3572-scaled.jpg)
![Eyak River Boat Ramp Installation Cordova, AK 2022](https://www.aquadam.net/content/uploads/2023/12/13Deploying-main-8-X-357-AquaDam-scaled.jpg)
Starting deployment of the 8' X 357' AquaDam. The worker is holding the AquaDam back so it can maintain head above water and contact with the ground. AquaDams float when empty.
![Eyak River Boat Ramp Installation Cordova, AK 2022](https://www.aquadam.net/content/uploads/2023/12/14AquaDam-maintaining-Head-above-water-scaled.jpg)
The AquaDam roll has to be held back and slowly released so it can maintain head above water which means it is maintaining contact with the waters bottom.
![Eyak River Boat Ramp Installation Cordova, AK 2022](https://www.aquadam.net/content/uploads/2023/12/158-X-357-unroll-being-controlled-from-shore-scaled.jpg)
AquaDam being controlled from shore with rope.
![Eyak River Boat Ramp Installation Cordova, AK 2022](https://www.aquadam.net/content/uploads/2023/12/168-X-357-Making-turn-around-Deadman-scaled.jpg)
8' X 357' AquaDam making first turn from upstream to downstream around the end of the Dead-man AquaDam.
![Eyak River Boat Ramp Installation Cordova, AK 2022](https://www.aquadam.net/content/uploads/2023/12/178-X-357-on-last-turn-deadheading-into-shore-scaled.jpg)
AquaDam getting manipulated into its last turn from shore with rope.
![Eyak River Boat Ramp Installation Cordova, AK 2022](https://www.aquadam.net/content/uploads/2023/12/188-X-357-unrolling-back-to-shore-scaled.jpg)
Workers guiding AquaDam to shore.
![Eyak River Boat Ramp Installation Cordova, AK 2022](https://www.aquadam.net/content/uploads/2023/12/198-X-357-Roll-being-held-back-scaled.jpg)
Workers holding back AquaDam to let it build more head.
![Eyak River Boat Ramp Installation Cordova, AK 2022](https://www.aquadam.net/content/uploads/2023/12/208-X-357-approaching-bank-scaled.jpg)
AquaDam slowly making its way up the bank.

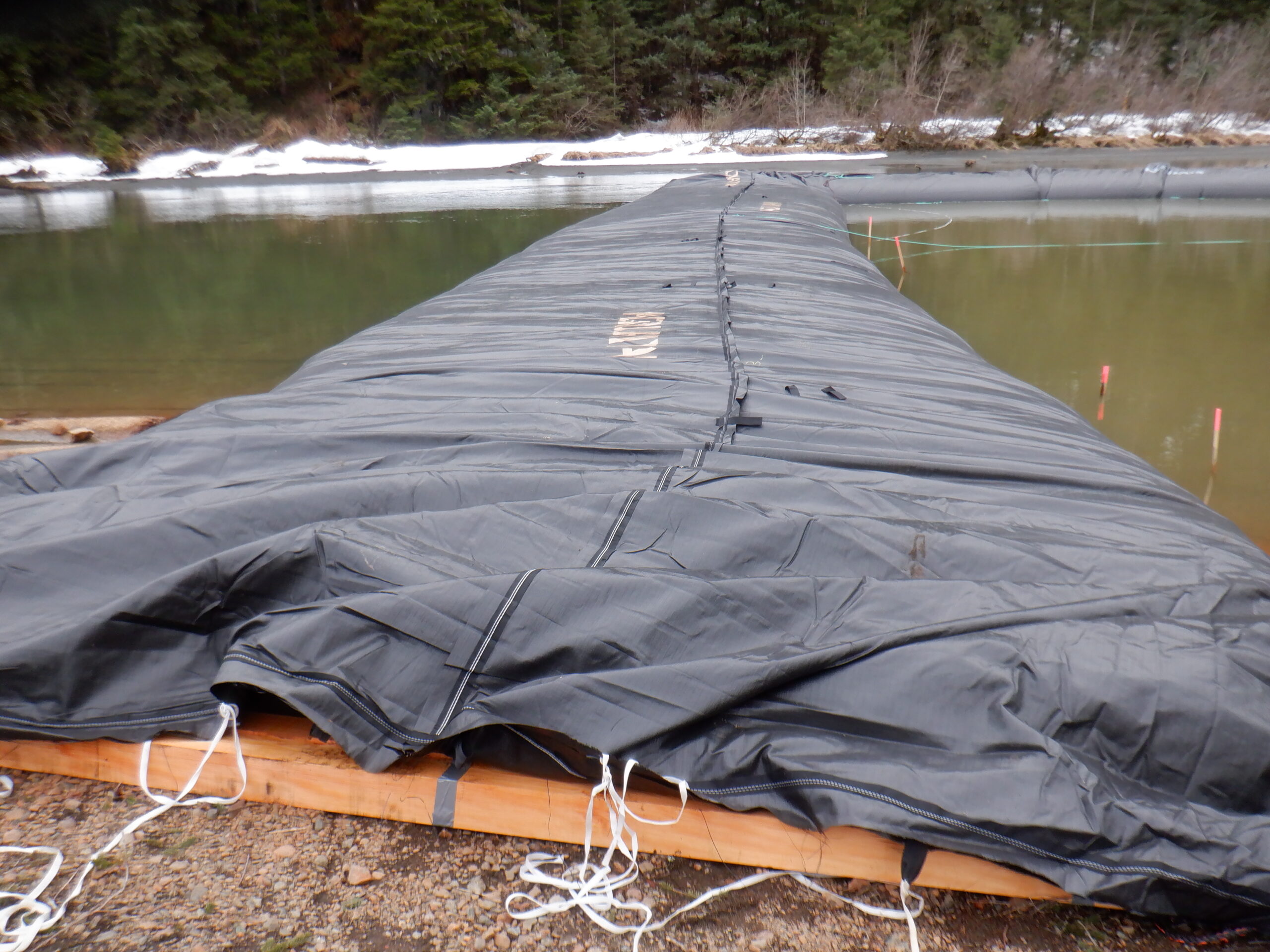

![Eyak River Boat Ramp Installation Cordova, AK 2022](https://www.aquadam.net/content/uploads/2023/12/21Elevation-profile-picture-of-ending-bank-scaled.jpg)
Profile view of the ending bank for the 8' X 357' AquaDam.
Beam at the end of the 8' X 357' AquaDam was used for center core of AquaDam for transportation and assisting during unrolling.

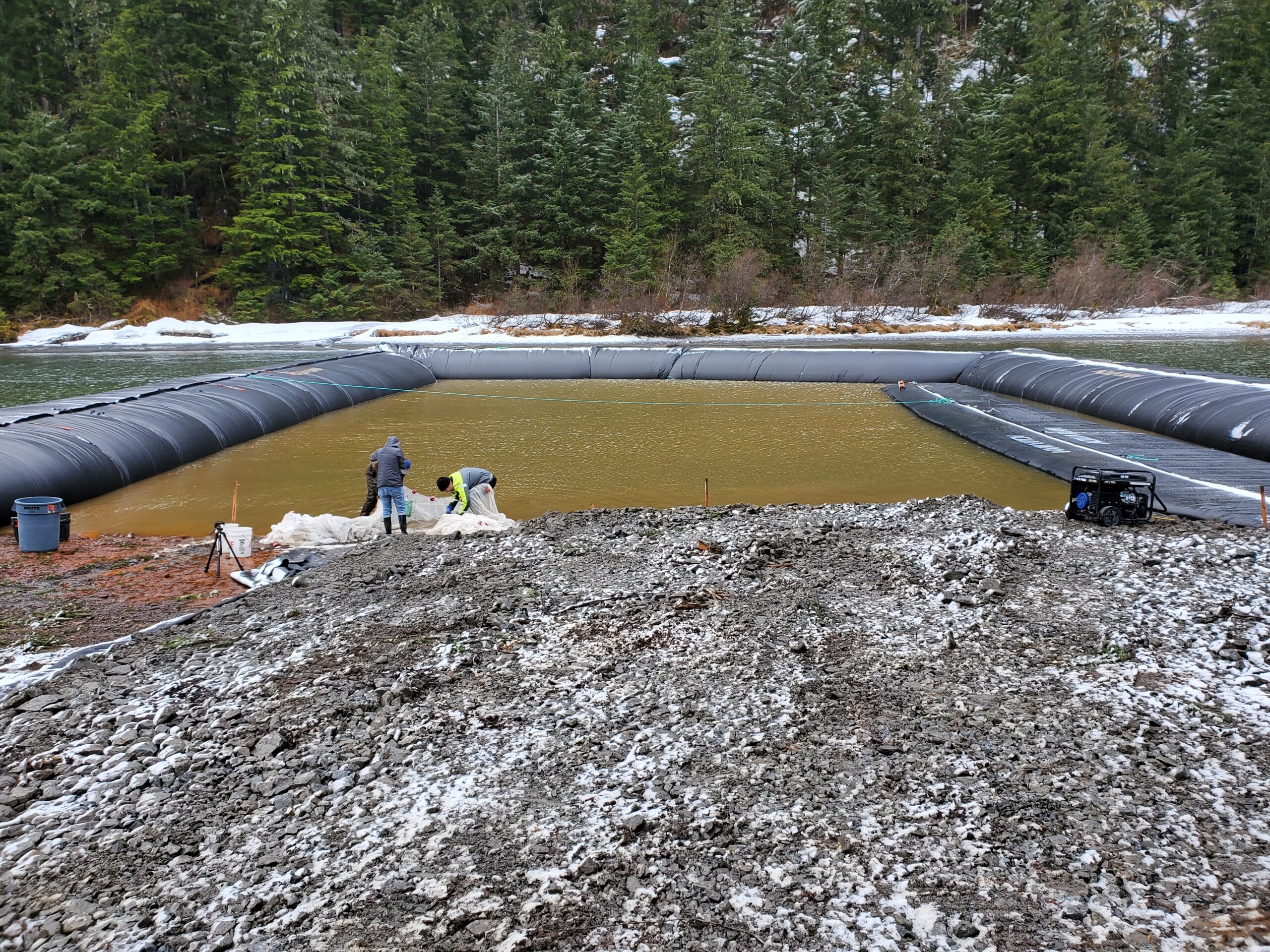

8' X 357' AquaDam fully installed. A crew is making sure that no fish are in the work area.

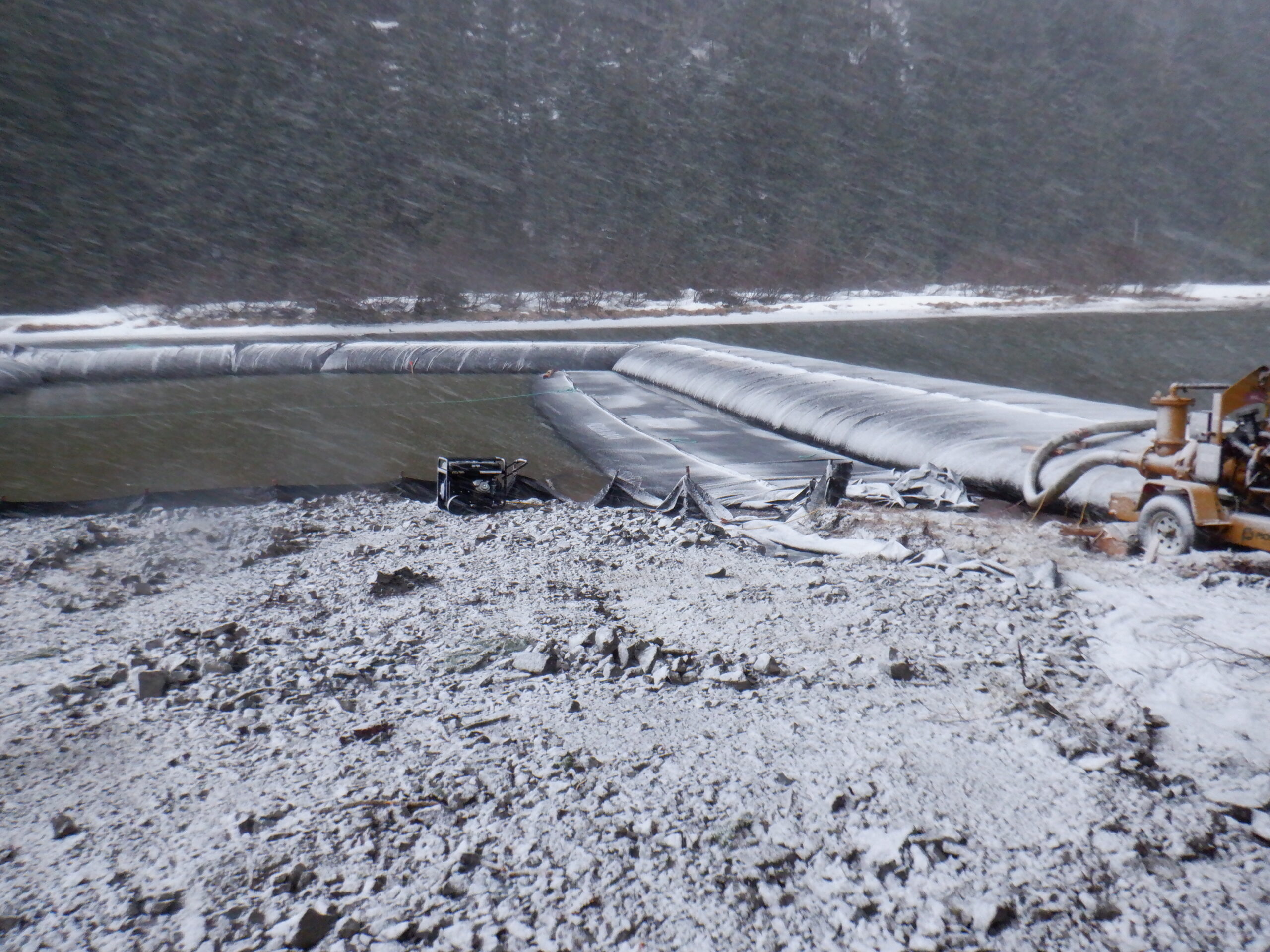

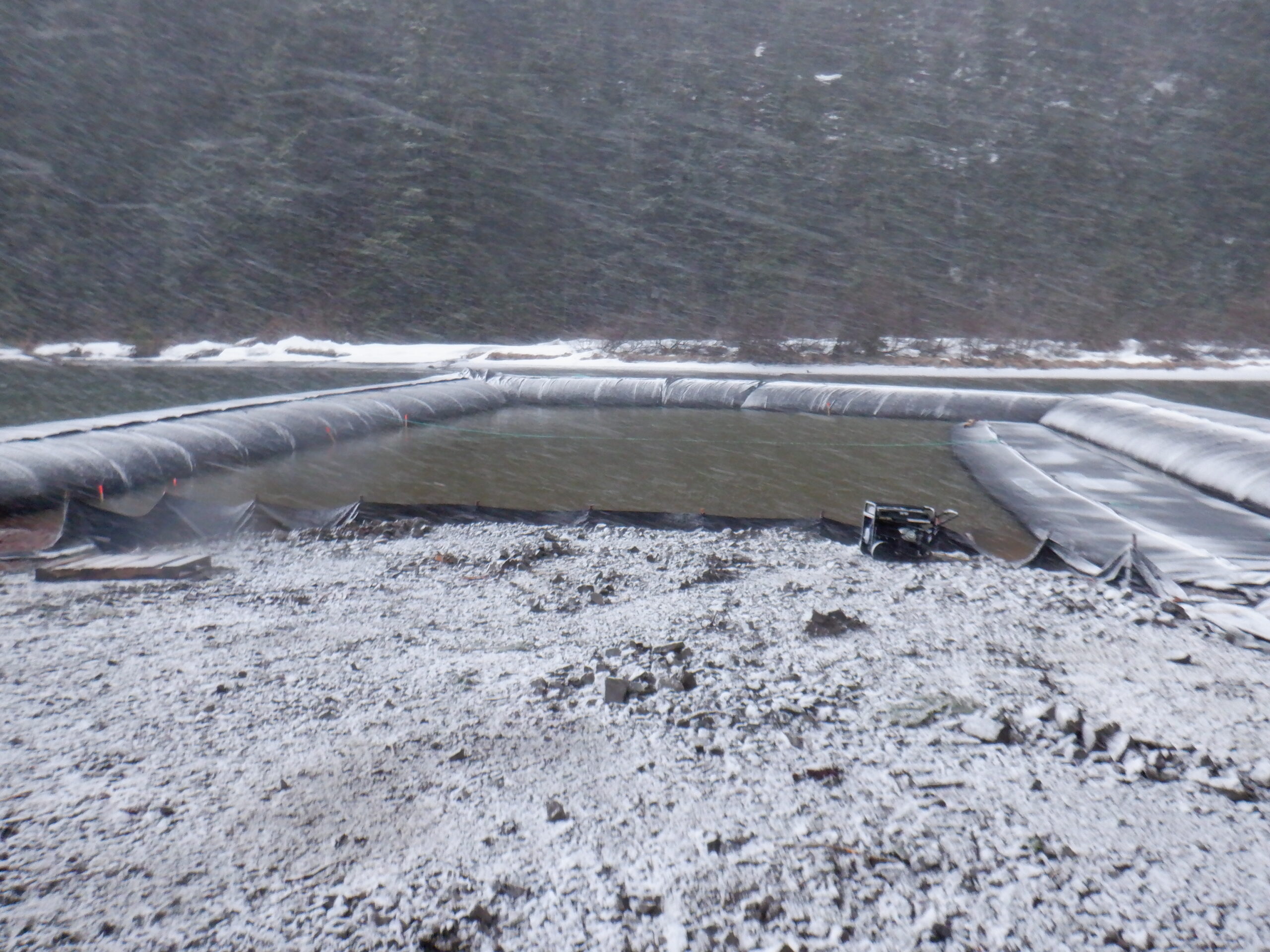

AquaDam in snow storm.

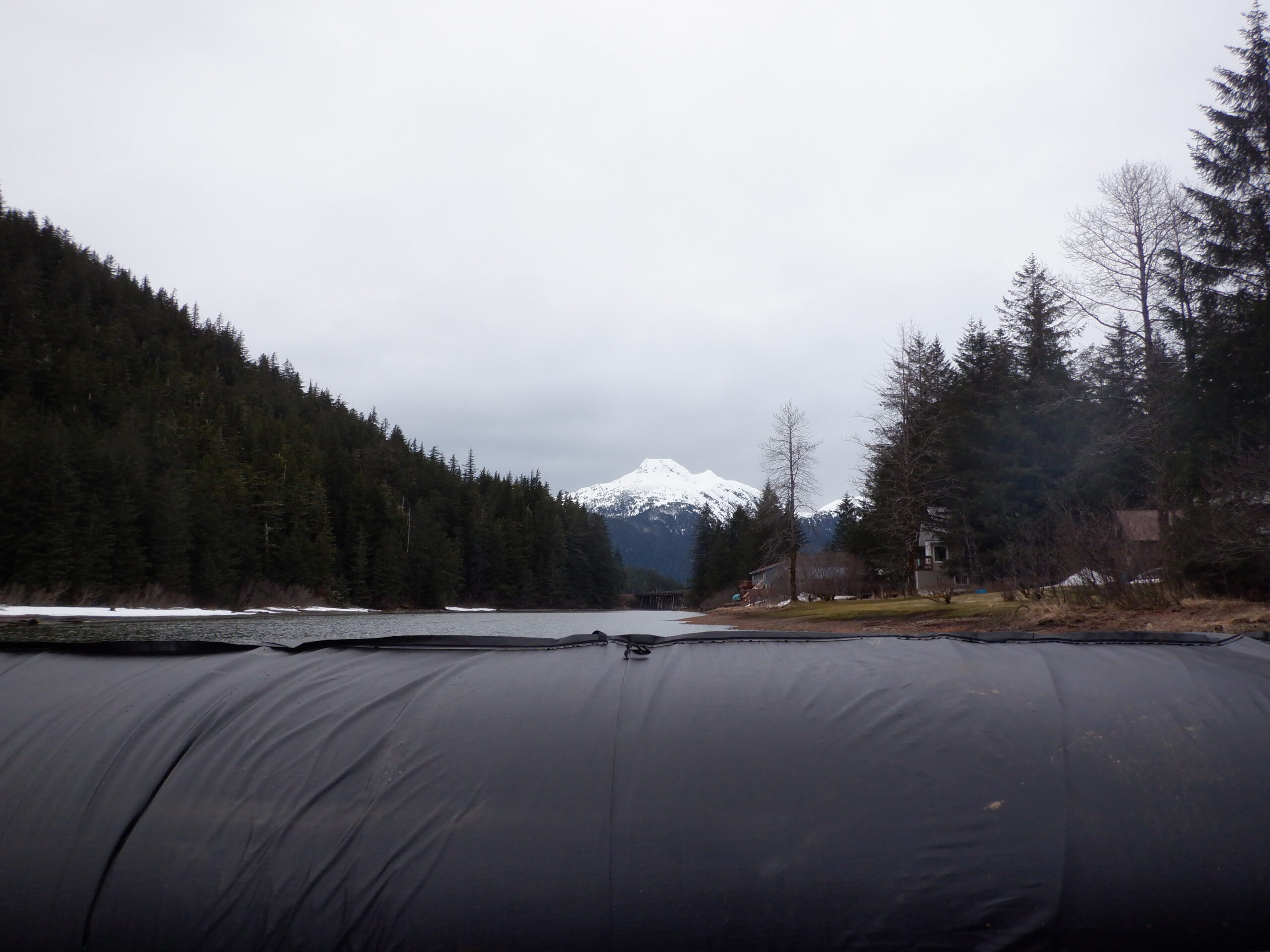

View of Mount Eyak from the internal work area.
